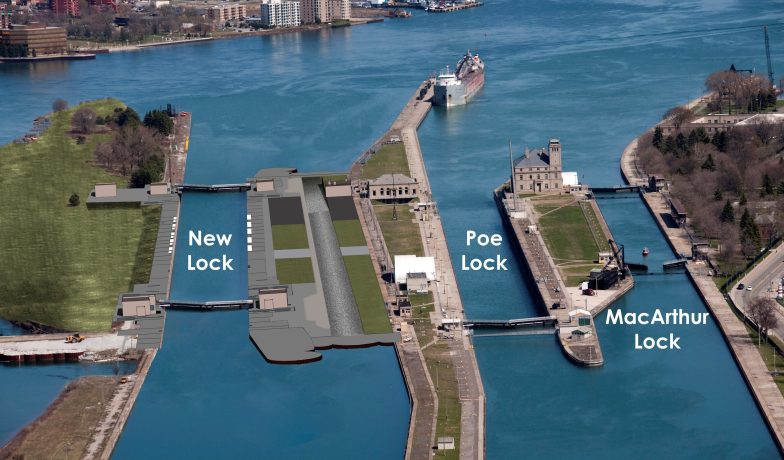

Remaining Phase 3 Options Awarded for New Lock at the Soo
U.S. Army Corps of Engineers, Detroit District’s New Lock at the Soo project in Sault Ste. Marie, Michigan, has awarded a total of $95.3 million for remaining Phase 3 options to Kokosing Alberici Traylor, LLC (KAT) of Westerville, Ohio.
The remaining Phase 3 options include Option 4: Downstream Work ($44.9 million), Option 5: Hands Free Mooring ($24.2 million), and Option 6: Downstream Ship Arrestors ($26.2 million).
Negotiated pricing on the remaining Phase 3 options was set to expire in September 2025.
“With an early award of the remaining Phase 3 options, the project continues to be on track for completion in 2030,” said Detroit District’s Senior Civilian Kevin McDaniels.
The New Lock at the Soo project is being built in three phases. Phase 1 (Upstream Channel Deepening) was completed in 2022 and Phase 2 (Upstream Approach Walls) was completed in 2024. The Phase 3 contract was awarded to KAT in July 2022 with a base contract at $1.068 billion. Awarding the base contract allowed the contractor to begin work in 2022 with the remaining work (contract options), to be awarded over the next three years.
Construction of Phase 3 began in late 2022, and given continued efficient funding is expected to last seven years. The New Lock at the Soo will be constructed in the footprint of the Sabin Lock and will be the same size as the Poe Lock (1,200 feet long, 110 feet wide and 32 feet deep).
“The contractor has completed nearly $600 million worth of work through the end of May 2025,” said New Lock at the Soo Senior Project Manager Mollie Mahoney. “With the ongoing new concrete monoliths construction, the new lock walls are beginning to take shape on the downstream end of the project site. Demolition of the existing Sabin Lock concrete continues, and bedrock excavation in the footprint of the new lock chamber is steadily progressing. In the Davis Lock, the New Pump Well walls are being constructed, and the remainder of the chamber continues to be filled with excavated material.”
The main focus of construction over the next year will continue to be concrete monolith placement as well as Sabin Lock demolition and bedrock excavation.
The Soo Locks allow vessels to transit the 21-foot elevation change at the St. Marys Falls Canal. More than 88% of commodity tonnage through the Soo Locks is restricted by vessel size to the Poe Lock.
